Special Economic Zones / Application for a Special Economic Zone user license

Summary of the procedure

List of steps

List of steps (17)
1
Obtain an appointment with the developer to visit the zone and identify the land to be purchased
2
Lease land from the developer
3
Create user account and submit ESIA application Online procedure
4
Site visit
5
Obtain notification that ESIA is necessary Online procedure
6
Obtain ESIA study report
7
Submit the ESIA study report Online procedure
8
Obtain electronic copy of the ESIA certificate Online procedure
9
Obtain ESIA certificate and sign conditions of approval
10
Pay fee for construction permit
11
Submit request for construction permit Online procedure
12
Obtain construction permit Online procedure
13
Submit application for occupational permit Online procedure
14
Site Inspection
15
Obtain occupational permit Online procedure
16
Submit application for SEZ user license and pay application fee Online procedure
17
Obtain SEZ user license Online procedure

Where to go?

Prime Economic Zone Secretariat (x 2)
1 2
Prime Economic Zone Secretariat
One Stop Centre Registration Portal (x 4)
3 5 7 8
One Stop Centre Registration Portal
Rwanda Development Board (x 9)
4 9 11 12 13 14 15 16 17
Rwanda Development Board
Environmental Impact Assessment Experts
6
Environmental Impact Assessment Experts
National Bank of Rwanda
10
National Bank of Rwanda

What you will get

EIA certificate (original, signed and with stamp)
9
EIA certificate (original, signed and with stamp)

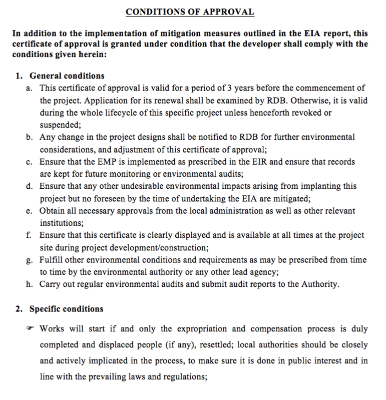

Signed conditions of approval
9
Signed conditions of approval
SEZ user license
17

Required documents

Project brief
3

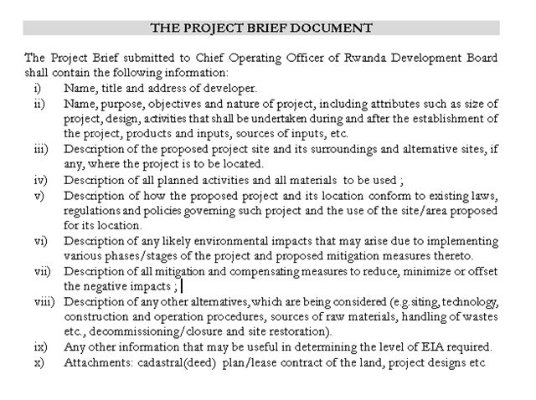

Project brief

Terms of reference for ESIA study
3
Terms of reference for ESIA study

Perspective and site layout plans
3
Perspective and site layout plans
Land ownership
3
Land ownership

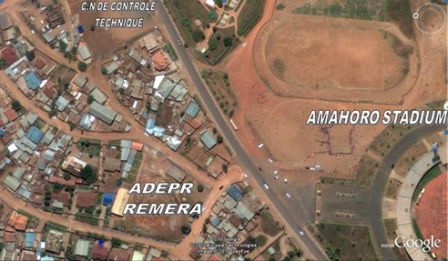

Location maps
3
Location maps
Panoramic view
3
Panoramic view
Proof of identity (x 2)
3 9
Proof of identity
EIA study report
7
EIA study report

Deposit slip

10
Deposit slip
Payment receipt (BNR)
11
Payment receipt (BNR)
EIA certificate (original, signed and with stamp)
11
EIA certificate (original, signed and with stamp)

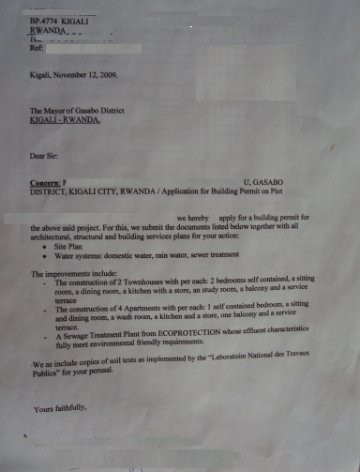

Application letter for construction permit
11
Application letter for construction permit
Project implementation plan
11
Project implementation plan

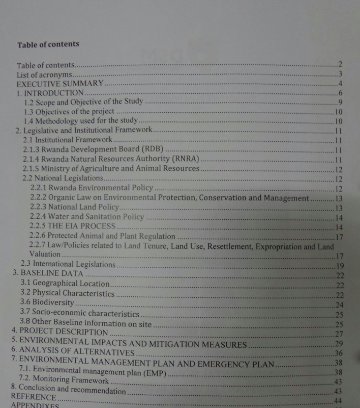

Environmental management plan.
11
Environmental management plan.

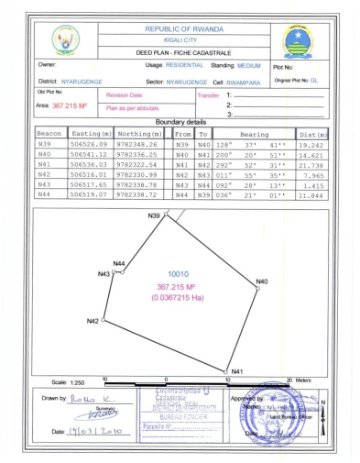

Deed plan
11
Deed plan

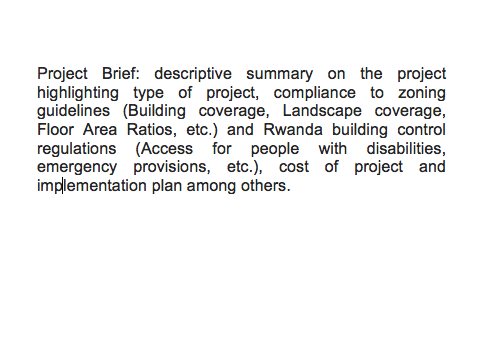

Project brief for construction permit
11
Project brief for construction permit

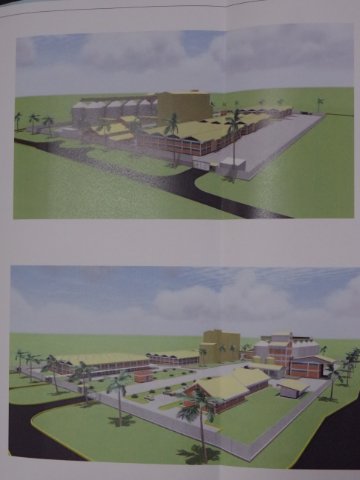

Two Perspectives vis a vis surroundings
11
Two Perspectives vis a vis surroundings
Topographic map

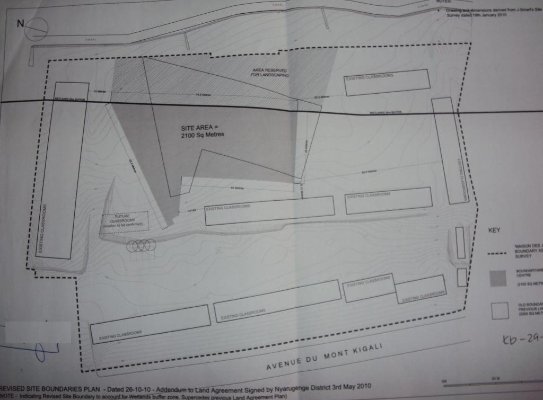

11
Topographic map

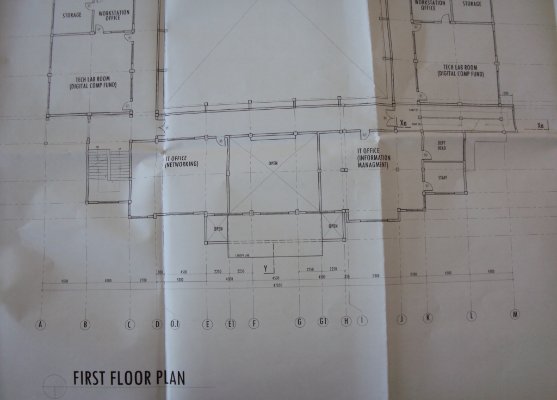

Architectural layout drawings
11
Architectural layout drawings

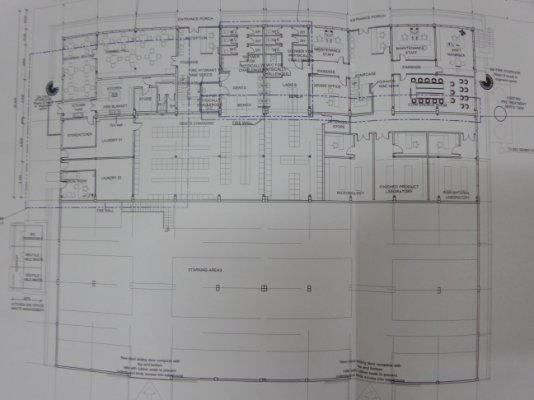

Water, plumbing and drainage drawings and details
11
 Water, plumbing and drainage drawings and details

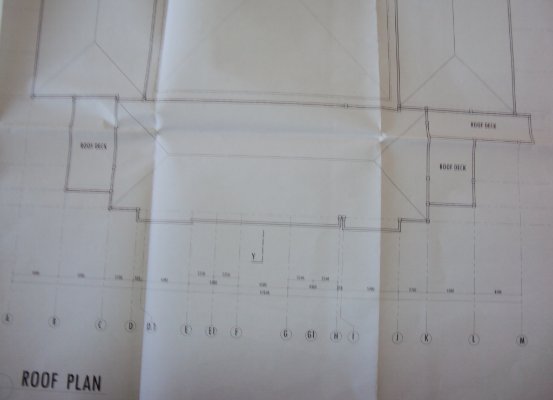

General arrangement of artificial ventilation
11
General arrangement of artificial ventilation
Electrical, mechanical or fibre optical installation layout details
11

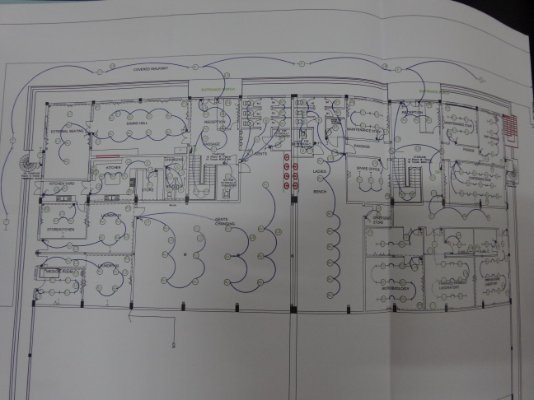

 Electrical, mechanical or fibre optical  installation layout details

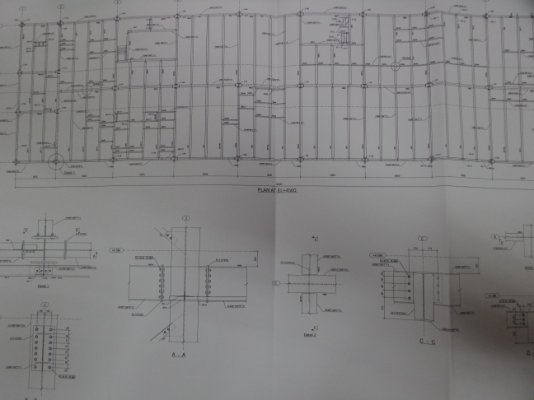

Structural drawings, layout and details, including bar bending schedule and structural calculations
11
Structural drawings, layout and details, including bar bending schedule and structural calculations
Bills of quantity
11
Bills of quantity
Soil test results
11
Soil test results

Safety measure plan (Fire Management)
11
Safety measure plan (Fire Management)
Appointment
12
Appointment

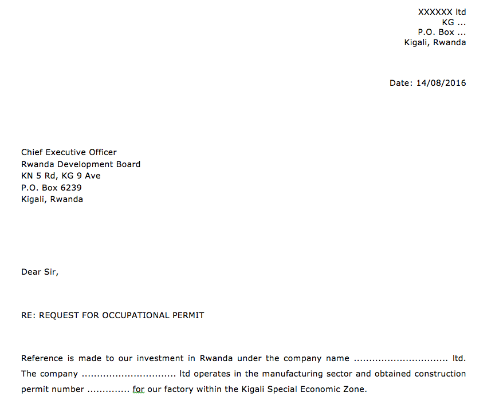

Application letter
13
Application letter

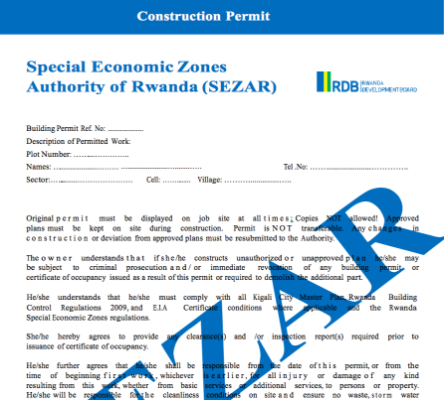

Construction permit
13
Construction permit
Application form for a Zone user license
16
Application form for a Zone user license
Certificate of domestic company registration

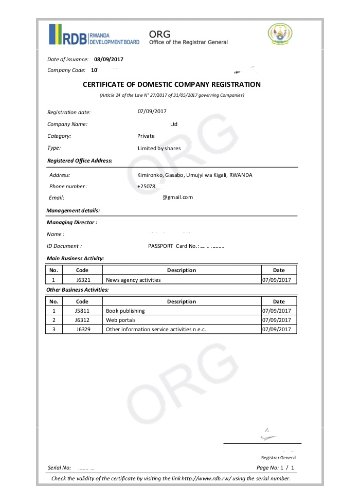

16
Certificate of domestic company registration
Memorandum of association

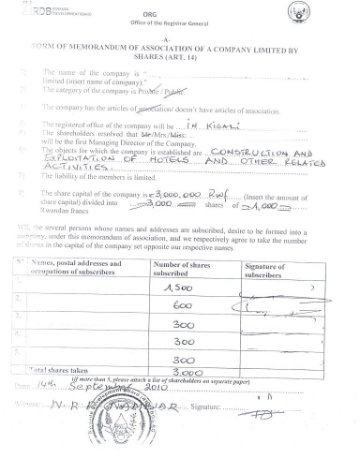

16
Memorandum of association
Shareholders resolution appointing board members, chairman and CEO

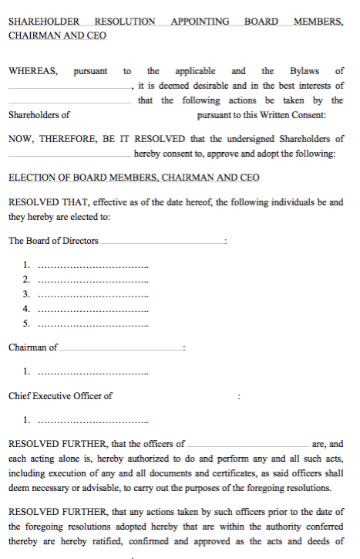

16
Shareholders resolution appointing board members, chairman and CEO

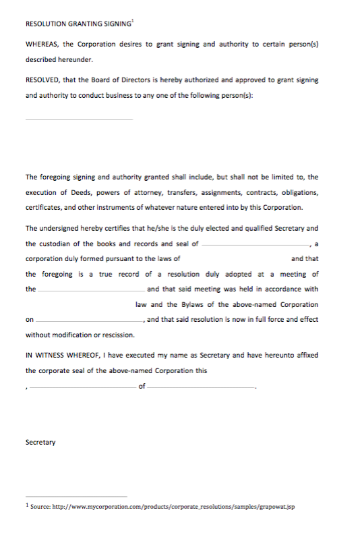

Resolution granting signing
16
Resolution granting signing
List of shareholders with respective shareholding
16

List of shareholders with respective shareholding

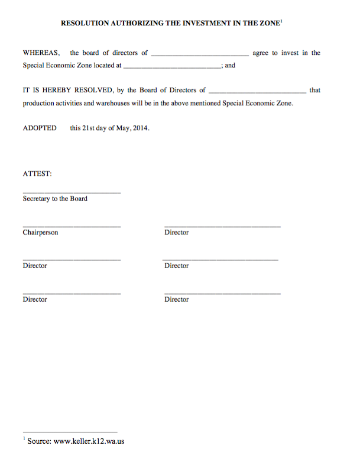

Resolution authorizing the investment in the Zone
16
Resolution authorizing the investment in the Zone
Business plan
16

Business plan
Representatives
Power of attorney
9
Power of attorney
Proof of identity
9
Proof of identity

How much?

Estimated cost of the procedure : RWF  60,000
RWF  60,000 (  fee for construction permit)

How long ?

  min. max.
Total time (sum): 4d 1/2 57d
of which:
Waiting time in queue (sum): 0mn 10mn
Attention at counter: 2h. 25mn 1d 1/2
Waiting time until next step (sum): 4d 55d

Legal justification?

Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment  Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
  ( Article 8 )
General guidelines and procedure for environment impact assesment  General guidelines and procedure for environment impact assesment
  ( Article 2 )
Law on environment  Law on environment
  ( articles 30-34, 30, 32 )
Ministerial Order N°004 establishing the list of works, activities and projects that have to undertake  an environment impact assessment  Ministerial Order N°004 establishing the list of works, activities and projects that have to undertake an environment impact assessment
  ( articles 2, 4 and annex )
RDB Public Notice - 17 March 2020  RDB Public Notice - 17 March 2020
Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users  Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users
  ( articles 3 & 4, 3&4 )

Detailed steps

1
Obtain an appointment with the developer to visit the zone and identify the land to be purchased

Contact details

Entity in charge

Prime Economic Zone Secretariat

8th Floor, Grand Pension Plaza P.O. Box 1321, Kigali
Website: http://www.pez.rw/

Unit in charge

Project Management

Mon: 09:00 - 17:00
Tue: 09:00 - 17:00
Wed: 09:00 - 17:00
Thu: 09:00 - 17:00
Fri: 09:00 - 17:00

Person in charge

Eng. Egide Mukono

Project Engineer
Tel: 0788300600
Email: egide.mukono@gmail.com

Expected results

1. 01 - Appointment
Appointment
2
Lease land from the developer

Contact details

Entity in charge

Prime Economic Zone Secretariat

8th Floor, Grand Pension Plaza P.O. Box 1321, Kigali
Website: http://www.pez.rw/

Unit in charge

Project Management

Mon: 09:00 - 17:00
Tue: 09:00 - 17:00
Wed: 09:00 - 17:00
Thu: 09:00 - 17:00
Fri: 09:00 - 17:00

Person in charge

Eng. Egide Mukono

Project Engineer
Tel: 0788300600
Email: egide.mukono@gmail.com

Expected results

3
Create user account and submit ESIA application

Timeframe ( see details )

Wait until next step

0 mn  -  0 mn
1 day  -  15 days

Contact details

Entity in charge

One Stop Centre Registration Portal

Tel: 1415 / +250 727 775 170
Email: onestop@rdb.rw, investorfeedback@rdb.rw
Website: http://osc.rdb.rw/en/

Expected results

1. 01 - Appointment
Appointment

Requirements

1. 01 - Libre deuda de patente
Project brief (original)
2. Terms of reference for ESIA study
Terms of reference for ESIA study (Simple copy)
3. 01 - Libre deuda de patente
Perspective and site layout plans (Simple copy)
4. 01 - Libre deuda de patente
Land ownership (Simple copy)
land ownership document can be any legally binding document that proves the rights of the project developer on a given piece of land. E.g.: deed plan, emphyteutic lease, a contract between the land owner and the developer, a ministerial order granting license (for mining projects), etc.
5. 01 - Libre deuda de patente
Location maps (Simple copy)
6. 01 - Libre deuda de patente
Panoramic view (Simple copy)
shows the site plans depends on the type of the project
7. 01 - Libre deuda de patente
E-mail account
of the person in charge of the project.
8. 01 - Libre deuda de patente
Contact details
of the person in charge of the project.
9. 01 - Libre deuda de patente
Proof of identity (Simple copy)
of the person in charge of the project.

Time frame

Attention at counter: Min.   20mn - Max.   30mn
Waiting time until next step: Min.   1 day - Max.   15 days

Legal justification

1. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
2. General guidelines and procedure for environment impact assesment
General guidelines and procedure for environment impact assesment
Article 2
3. Law on environment
Law on environment
Article 30-34

Additional information

If you do not see the verification email in your inbox after creating your account, please be sure to check your "spam" or "bulk" folders.

Once you click on the link provided in the verification email you are automatically logged into the system and you can start your application for EIA.

The mandatory spaces marked by red stars should be filled.

In case additional information is needed, the applicant receives a notification via email or phone text.

An appointment for site visit will be arranged after a complete application has been submitted and a focal person has been assigned.
4
Site visit

Timeframe ( see details )

Wait until next step

0 mn  -  10 mn
1 day  -  15 days

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

One Stop Center

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Requirements

1.
Physical presence
of applicant or any other representative with thorough knowledge of the project and the site. Should be able to show the boundaries of the site and give details of the project.

Time frame

Complex sites may require more than one site visit.
Attention at counter: Min.   30mn - Max.   6h.
Waiting time until next step: Min.   1 day - Max.   15 days

Legal justification

1. Law on environment
Law on environment
Article 32

Additional information

Site visits are an integral part of the screening process necessary to determine whether an environmental impact assessment is necessary. The client is informed on the date, time and any other arrangements for the site visit via a phone call by the assigned focal person.

Other stakeholders may join the team depending on the complexity of the project: representatives of Rwanda Environmental Management Authority, district environmental officers, land officers, etc.

5
Obtain notification that ESIA is necessary

Contact details

Entity in charge

One Stop Centre Registration Portal

Tel: 1415 / +250 727 775 170
Email: onestop@rdb.rw, investorfeedback@rdb.rw
Website: http://osc.rdb.rw/en/

Expected results

1. ESIA notification
ESIA notification

Requirements

1.
Physical presence
of the applicant or a representative

Time frame

Attention at counter: Min.   5mn - Max.   10mn

Legal justification

1. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
2. General guidelines and procedure for environment impact assesment
General guidelines and procedure for environment impact assesment See appendix 4 for sample Terms of Reference for EIA study
3. Ministerial Order N°004 establishing the list of works, activities and projects that have to undertake  an environment impact assessment
Ministerial Order N°004 establishing the list of works, activities and projects that have to undertake an environment impact assessment
articles 2, 4andannex
4. Law on environment
Law on environment
Article 30

Additional information

Terms of reference, transmission of terms of reference and list of EIA experts are uploaded in in the online application system by the assigned focal person.

Not all projects require an EIA. The focal person will advise on way forward after full assessment:
- Level 3: full EIA
- Level 2: partial EIA
- Level 1: non objection clearance (end of the process)

This step applies to outcome "Level 3": the focal person will send the terms of reference for the EIA study and a list of EIA experts to the applicant so that they can carry out the EIA study.

In case of outcome "Level 2", the applicant will receive a letter of approval and an environmental management plan with necessary guidelines.
If the outcome is "Level 1", the applicant will receive a letter of approval: "non objection clearance".
For Level 1 & 2, this will be the last step.
6
Obtain ESIA study report

Contact details

Entity in charge

Environmental Impact Assessment Experts

List of EIA experts List of EIA experts

Expected results

1. 01 - EIA study report
EIA study report

Time frame

Attention at counter: Min.   10mn - Max.   20mn

Legal justification

1. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
7
Submit the ESIA study report

Timeframe ( see details )

Wait until next step

0 mn  -  10 mn
1 day  -  20 days

Contact details

Entity in charge

One Stop Centre Registration Portal

Tel: 1415 / +250 727 775 170
Email: onestop@rdb.rw, investorfeedback@rdb.rw
Website: http://osc.rdb.rw/en/

Expected results

1. Application approved online notification
Application approved online notification

Requirements

1. 01 - Libre deuda de patente
EIA study report (original)

Time frame

Attention at counter: Min.   5mn - Max.   10mn
Waiting time until next step: Min.   1 day - Max.   20 days

Legal justification

1. General guidelines and procedure for environment impact assesment
General guidelines and procedure for environment impact assesment Part. 2.1.5
2. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
3. Law on environment
Law on environment
Article 30

Additional information

After verification of the EIA study report, the assigned focal person may have comments or request for additional information. In this case the applicant will be notified via email and SMS and he / she will be requested to send any additional information through the online application system.

For big projects, it might take more than 20 days after the submission of the EIA report to obtain an EIA Certificate. In this case, the client will be informed at the time of submission of the EIA report. The assigned focal person will call the applicant to let him/her know when the Environmental Impact Assessment (EIA) Certificate is ready.
8
Obtain electronic copy of the ESIA certificate

Contact details

Entity in charge

One Stop Centre Registration Portal

Tel: 1415 / +250 727 775 170
Email: onestop@rdb.rw, investorfeedback@rdb.rw
Website: http://osc.rdb.rw/en/

Expected results

1. EIA certificate (electronic copy)
EIA certificate (electronic copy)
2. 01 - Conditions of approval
Conditions of approval

Requirements

1. 01 - Libre deuda de patente
E-mail account

Time frame

Attention at counter: Min.   5mn - Max.   10mn

Legal justification

1. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
2. Law on environment
Law on environment
Article 30-34

Additional information

Even though the EIA certificate is received electronically, applicants will have to go to the OSC to sign the hard copy with the "conditions of approval".
9
Obtain ESIA certificate and sign conditions of approval

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

One Stop Center

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Expected results

1. 01 - EIA certificate (original, signed and with stamp)
EIA certificate (original, signed and with stamp)
2. 01 - Signed conditions of approval
Signed conditions of approval

Requirements

1.
Physical presence
or authorized representative
2. 01 - Libre deuda de patente
Proof of identity (original + Simple copy)
of the applicant (National ID or passport)
For authorized representative
1. 01 - Libre deuda de patente
Power of attorney (an authentic copy)
2. 01 - Libre deuda de patente
Proof of identity (original + Simple copy)
National ID or passport

Time frame

Attention at counter: Min.   5mn - Max.   10mn

Legal justification

1. Ministerial Order no 003/MoE/25 of 19/08/2025  relating to environmental and social impact assessment
Ministerial Order no 003/MoE/25 of 19/08/2025 relating to environmental and social impact assessment
Article 8
2. Law on environment
Law on environment
Article 30-34
10
Pay fee for construction permit

Contact details

Entity in charge

National Bank of Rwanda

Avenue Paul VI P.O. Box 531, Kigali
Tel: +250 252 591 204
Fax: +250 252 572 551
Website: http://www.bnr.rw/

Unit in charge

Currency and Banking operations department

Mon: 09:00 - 17:00
Tue: 09:00 - 17:00
Wed: 09:00 - 17:00
Thu: 09:00 - 17:00
Fri: 09:00 - 17:00

Person in charge

Cashier

Expected results

1. 01 - Payment receipt (BNR)
Payment receipt (BNR)

Requirements

1. 01 - Libre deuda de patente
Deposit slip (original)
duly filled and signed

Cost RWF 60,000

RWF expand_more expand_less
  • RWF Add Name Here
RWF 60,000
fee for construction permit
Payment methods: cash, check
The prescribed fee can also be paid at any other branch of Bank of Kigali, on SEZAR account number: 1000023414 (RWF).

Time frame

Waiting time in queue: Max.  10mn
Attention at counter: Max.   5mn
11
Submit request for construction permit

Timeframe ( see details )

Wait until next step

0 mn  -  0 mn
 -  2 days

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. 01 - Appointment
Appointment

Requirements

1. 01 - Libre deuda de patente
Payment receipt (BNR) (original)
2. 01 - Libre deuda de patente
EIA certificate (original, signed and with stamp) (original)
3. 01 - Libre deuda de patente
Application letter for construction permit (original)
The letter should be addressed to CEO RDB with copy to the Head of SEZAR and the Head of Prime Economic Zones (the Developer).
4. 01 - Libre deuda de patente
Project implementation plan (Simple copy)
5. 01 - Libre deuda de patente
Environmental management plan. (Simple copy)
6. 01 - Libre deuda de patente
Deed plan (original)
or sales agreement, if deed plan not yet available
7. 01 - Libre deuda de patente
Project brief for construction permit (original)
8. 01 - Libre deuda de patente
Two Perspectives vis a vis surroundings (original + 2 simple copies)
On A3 paper
9. 01 - Libre deuda de patente
Topographic map (original + 2 simple copies)
On A3 paper
10. 01 - Libre deuda de patente
Architectural layout drawings (4 simple copies)
On A0 paper
11. 01 - Libre deuda de patente
Water, plumbing and drainage drawings and details (4 simple copies)
On A4 paper
12. 01 - Libre deuda de patente
General arrangement of artificial ventilation (4 simple copies)
On A4 paper
13. 01 - Libre deuda de patente
Electrical, mechanical or fibre optical installation layout details (4 simple copies)
On A4 paper
14. 01 - Libre deuda de patente
Structural drawings, layout and details, including bar bending schedule and structural calculations (4 simple copies)
On A0 paper
15. 01 - Libre deuda de patente
Bills of quantity (2 simple copies)
16. 01 - Libre deuda de patente
Soil test results (Simple copy)
Where applicable
17. 01 - Libre deuda de patente
Safety measure plan (Fire Management) (Simple copy)

Time frame

Attention at counter: Min.   10mn - Max.   20mn
Waiting time until next step: Max.   2 days

Legal justification

1. RDB Public Notice - 17 March 2020
RDB Public Notice - 17 March 2020

Additional information

1) All drawings/plans must be stamped and signed by the design consultancy firm.
2) All designs or Site improvement activities shall be done in conformity with the relevant Rwanda laws, regulations and guidelines.
3) Where applicable, the details of any special provisions for persons with disabilities shall be given on all plans drawings and diagrams.
12
Obtain construction permit

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. Construction permit
Construction permit

Requirements

1. 01 - Libre deuda de patente
Appointment

Time frame

Attention at counter: Min.   5mn - Max.   10mn
13
Submit application for occupational permit

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. 01 - Appointment
Appointment

Requirements

1. Application letter
Application letter (original)
2. Construction permit
Construction permit (Simple copy)
14
Site Inspection

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. 01 - Appointment
Appointment

Requirements

1.
Physical presence
of the applicant or representative

Time frame

Attention at counter: Min.   30mn - Max.   1h.

Additional information

In addition to the applicant, the site visit takes place in presence of the SEZAR Engineer, the PEZ Engineer, the Construction Supervisor and a representative of the Fire Brigade.
15
Obtain occupational permit

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. Occupational permit
Occupational permit

Requirements

1.
Physical presence
of the applicant or their representative

Time frame

Attention at counter: Min.   5mn - Max.   10mn
16
Submit application for SEZ user license and pay application fee

Timeframe ( see details )

Wait until next step

0 mn  -  5 mn
1 day  -  3 days

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. 01 - Appointment
Appointment

Requirements

1. Application form for a Zone user license
Application form for a Zone user license (original)
duly filled and signed
2. 01 - Libre deuda de patente
Certificate of domestic company registration (Simple copy)
3. 01 - Libre deuda de patente
Memorandum of association (Simple copy)
4. Shareholders resolution appointing board members, chairman and CEO
Shareholders resolution appointing board members, chairman and CEO (Simple copy)
5. Resolution granting signing
Resolution granting signing (Simple copy)
6. 01 - Libre deuda de patente
List of shareholders with respective shareholding (Simple copy)
7. Resolution authorizing the investment in the Zone
Resolution authorizing the investment in the Zone (Simple copy)
8. 01 - Libre deuda de patente
Business plan (original)
with detailed description of the planned economic activities and action plan including the proposed timeframe to commence activities

Time frame

Attention at counter: Min.   10mn - Max.   20mn
Waiting time until next step: Min.   1 day - Max.   3 days

Legal justification

1. Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users
Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users
Article 3&4
17
Obtain SEZ user license

Contact details

Entity in charge

Rwanda Development Board

Petrocom Building KN 69 Street, Kigali P.O Box 6239
Tel: 1415 / +250 788 321 555
Email: info@rdb.rw, support@rdb.rw
Website: https://www.rdb.rw
Directions: Google maps

Unit in charge

Special Economic Zones Authority Department

Mon: 09:00 - 17:00, 00:00 - 00:00
Tue: 09:00 - 17:00, 00:00 - 00:00
Wed: 09:00 - 17:00, 00:00 - 00:00
Thu: 09:00 - 17:00, 00:00 - 00:00
Fri: 09:00 - 15:00, 00:00 - 00:00
Sat: closed
Sun: closed

Person in charge

Hubert Kisembo

Civil Engineer Specialist
Tel: +250785715352
Email: hubert.kisembo@rdb.rw

Expected results

1. SEZ user license
SEZ user license

Requirements

1.
Physical presence
of the applicant or representative

Time frame

Attention at counter: Min.   5mn - Max.   20mn

Legal justification

1. Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users
Regulation No. 03/2012/SEZAR adopted on 20/12/2012 Regulation on the Special Economic Zones Users
Article 3&4
